Wednesday, November 16, 2022
United Oil and Gas provided an update on the testing of the ASH-4 development well (ASH-4) in the Abu Sennan license, onshore Egypt. United holds a 22% non-operating interest in the Abu Sennan license, which is operated by Kuwait Energy Egypt.
Summary
– Preliminary test results from the ASH-4 well-test indicate a flowrate of 2,101 bopd and 3 mmscf/d (c. 2,700 boepd gross; 594 boepd net) from the Alam El Bueib (AEB) reservoir on a maximum 40/64” choke
– On a reduced, 32/64” choke, which is expected to be more representative of the producing flow rates, the well flowed at 1,325 bopd and 1.8 mmscf/d (c. 1,685 boepd gross; 371 boepd net)
– ASH-4 is expected to be tied into the existing facilities and brought on stream in the coming days
– The ST-1 rig will now move to the ASW-1X exploration well location to commence drilling the fifth well in the 2022 program
– Stimulation program expected to be completed on the AJ-14 well over the coming weeks
United Chief Executive Officer, Brian Larkin commented: “We are very pleased with the news of the ASH-4 initial well test result. It is expected that the well will be brought onstream in the coming days and will immediately contribute production and revenue for the Company. The ASH field has proved to be a prolific area of the Abu Sennan license and we are pleased to be reporting this positive well test result, as we move to drill the final well of the 2022 drilling program. This will be the ASW-1X exploration well (previously named ASF-1X) which is targeting 8mmbbls of gross recoverable resources.”

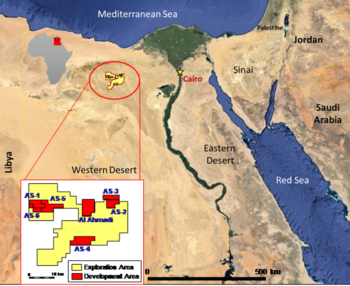

ASH- 4 well
The ASH-4 development well, a step-out development well in the ASH field, encountered 20 meters of net pay through the primary Alam El Bueib reservoir target as announced on 28 October 2022.
ASH-4 reached TD of 4,000 meters on October 29 and was successfully tested from the targeted AEB formation. Preliminary results indicate average flow rates of 2,101 bopd and 3 mmscf/d (c. 2,700 boepd gross; 594 boepd net working interest) on a maximum 40/64” choke. Rates of 1,325 bopd and 1.8 mmscf/d (c. 1,685 boepd gross; 371 boepd net working interest) were achieved on a reduced 32/64” choke, with no water production. The rates on the smaller 32/64” choke size are expected to be more representative of the sustainable flow levels that will be achieved when the well is brought onstream through the existing ASH facilities in the coming days.
ASW-1X (previously named ASF-1X)
The ST-1 rig will now move to the site of the ASW-1X exploration well which will be the fifth and final well in the 2022 drilling campaign. This well will target un-risked mean recoverable resources estimated by United at approximately 8 mmbbls gross in multiple reservoirs to the south-west of the ASH field. This is a key well, not just for the significant volumes that it is targeting directly, but also for the potential to de-risk a number of other similar structures in this portion of the license. A further update on the commencement of drilling will be made in due course.
AJ-14 well update
As previously announced, the AJ-14 development well encountered seven meters of net pay in the primary Abu Roash-C (ARC) target. A comprehensive technical review to optimize the forward options for this well has now been carried out by the JV partners. Following this review, and the availability of a workover rig, it is now expected that a stimulation program will be completed on the AJ-14 well over the coming weeks. Well stimulation has previously delivered successful results on a number of Abu Sennan wells, and on completion, commercial flowrates in line with the pre-drill expectations of c. 300bopd gross are expected to be established from this well.
